Adaptive Project Controls and Artifacts
Not sure you’re ready?
Take the ~3-minute readiness diagnostic and see where you stand.
When building a suspension bridge, a civil engineer relies on a static blueprint where the sequence of every cable and rivet is fixed before construction begins. If a project manager wants to know how the bridge is doing, they look at a baseline plan and measure schedule variance. But when a team is developing a new software platform or launching a dynamic marketing campaign, the landscape—customer preferences, technology, competitor moves—changes while the work is actively underway. In these unpredictable environments, rigid blueprints do not secure success; they guarantee obsolescence.
Instead of guessing the future, adaptive project management teams run continuous, controlled experiments. They build a piece of the product, show it to the user, observe reality, and adjust their course. This fundamental shift requires entirely different tools for tracking progress. Rather than burying project status in a weekly spreadsheet, adaptive teams rely on visual, living representations of their work that actively inform their next move.
In traditional, predictive project management, control means adhering to a plan. In adaptive environments, control means responding to reality. Adaptive project controls rely on empirical process control rather than predictive upfront planning.
Empirical process control acknowledges that we cannot perfectly forecast complex work. Instead, it demands that we make decisions based on what we can actually observe and measure. This approach is supported by three foundational pillars: transparency, inspection, and adaptation.
- Transparency: Everyone must be able to see the true state of the work.
- Inspection: The team must frequently examine the work to detect undesirable variances.
- Adaptation: If an inspector determines that the work is drifting outside acceptable limits, the process or the materials must be adjusted immediately.
Because of these three pillars, adaptive project controls are documented continuously through living artifacts like product backlogs and task boards rather than static baseline plans. A baseline plan is a historical snapshot of an assumption. A living artifact tells you exactly where you stand right now.
To maximize transparency, adaptive teams utilize an information radiator.
An information radiator is a highly visible physical or digital display that shows project progress and status to all stakeholders.
Think of an information radiator like a scoreboard at a basketball game. You don't have to email the referee to find out who is winning; you just look up. When progress is displayed openly, the team can continuously inspect and adapt without waiting for a formal status meeting.

Furthermore, how we measure success shifts entirely. Agile metrics favor the empirical measurement of delivered value and working software over traditional predictive metrics like Schedule Variance. Knowing that you are "two weeks behind schedule" on a flawed baseline is useless. Knowing that you just delivered a feature that increased user retention by 5% is invaluable.
In predictive projects, scope is locked in a massive requirements document. In adaptive projects, scope is fluid, modular, and documented from the perspective of the people who will actually use the end product.
At the highest level, large initiatives are captured as an Epic. An Epic is a large agile artifact that represents a substantial body of work requiring breakdown into smaller pieces. You can think of an epic as a big, audacious goal—like "Create a mobile banking application." It is too large to complete in a few weeks, so it must be dismantled into digestible parts.
These smaller parts are known as User Stories. A User Story is an agile artifact containing a brief description of a product requirement written from the perspective of the end user. It usually follows a simple syntax: "As a [type of user], I want [some feature] so that [some value is created]." This ensures the team never loses sight of why a piece of work matters.
All of these requirements must live somewhere. They reside in the Product Backlog.
A Product Backlog is an emergent, ordered list of everything that is known to be needed to improve or create a product.
Notice the word emergent. The Product Backlog is never "finished." As long as the product exists, the backlog evolves. New ideas are added; obsolete ideas are deleted. To prevent chaos, this list requires a definitive gatekeeper. The Product Owner is the single role accountable for managing and prioritizing the Product Backlog. The Product Owner ensures that the most valuable work is always at the top of the list.
When an agile team is ready to work, they operate in short timeboxes called Iterations, or Sprints. The mechanics of a Sprint are tightly controlled by specific artifacts and ceremonies designed to force regular inspection and adaptation.
To start an iteration, the team establishes a Sprint Goal, which is a commitment objective set for an iteration that provides guidance to the agile team on why the increment is being built. The Sprint Goal is the "North Star" for the next couple of weeks.
With the goal in mind, the team pulls high-priority items from the Product Backlog into the Sprint Backlog.
A Sprint Backlog contains the Product Backlog items selected for the iteration and an actionable plan for delivering the work.
Once the sprint begins, the team meets every single day. This is called the Daily Standup, a short daily meeting used as an agile control mechanism to inspect iteration progress and adapt the near-term plan. It is not a status report to a manager; it is a tactical huddle for the team to coordinate their day and flag any roadblocks.

The ultimate output of an iteration is the Increment. An Increment is a concrete, usable stepping stone toward the ultimate product goal in an adaptive project. To ensure the Increment is truly valuable and not just half-finished code or draft documents, the team relies on a Definition of Done.
The Definition of Done is a formal description of the state of the Increment when all required quality measures are met.
If a User Story does not meet the Definition of Done, it is not part of the Increment. It goes back to the backlog. There is no such thing as "90% done" in agile. It is either done, or it is not.
Finally, at the end of the iteration, the team must inspect how they worked. They hold a Sprint Retrospective, an adaptive project control mechanism used to inspect team processes and identify continuous improvements. While the Daily Standup inspects the work, the Retrospective inspects the workflow.
Project coordinators and specialists must understand how to read the visual artifacts that track an agile team's pace and trajectory.
The most fundamental metric of speed is Velocity. Velocity is a measure of the total amount of work an agile team successfully completes during a single iteration. If a team completes 30 story points in Sprint 1, 32 in Sprint 2, and 28 in Sprint 3, their average velocity is 30. This historical data allows the Product Owner to forecast how much work the team can handle in future sprints.
To visualize progress over time, teams use two distinct types of charts:
The Burndown Chart
A burndown chart is an agile artifact providing a graphical representation of the total amount of work left to do versus time. Imagine a graph where the Y-axis is "Story Points Remaining" and the X-axis is "Days in the Sprint." The line should trend steadily downward until it hits zero on the last day.
However, reality is rarely a perfectly straight line. You must know how to interpret deviations. An upward trend line on a burndown chart indicates that work is being added to the project scope faster than work is being completed. If the team finishes 5 units of work, but the Product Owner discovers a bug that adds 10 units of work, the line spikes upward. The team is bailing water, but the ship is taking on water faster than they can bail.

The Burnup Chart

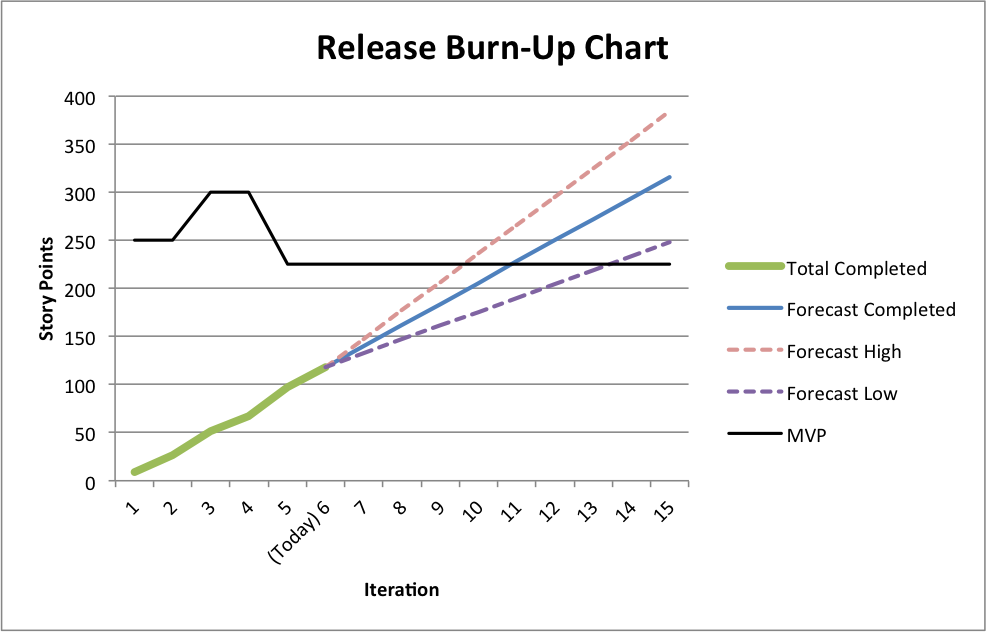

While a burndown chart shows work remaining, a burnup chart is an agile artifact that tracks the total amount of work completed toward the release of a product over time. The completed work line travels upward.
Why use both? Because a burndown chart hides scope creep. If your burndown line goes flat, you can't tell if the team stopped working, or if they did a lot of work but the total scope increased by the same amount. A burnup chart explicitly displays changes in project scope by adjusting a dedicated total scope line. By looking at a burnup chart, you can clearly see the "Completed Work" line rising to meet the "Total Scope" line. If the Total Scope line suddenly jumps up mid-project, the visual impact of that scope change is highly transparent to all stakeholders.

| Feature | Burndown Chart | Burnup Chart |
|---|---|---|
| Primary Focus | Work remaining to be done. | Work completed over time. |
| Scope Changes | Hard to isolate; can cause confusing upward spikes. | Explicitly displays changes in project scope via a dedicated top line. |
| Best Used For | Micro-tracking within a single Sprint. | Macro-tracking across a full project or release. |
Not all adaptive projects use timeboxed Sprints. Many IT operations, support desks, and continuous delivery teams use flow-based agile, heavily relying on Kanban.
A Kanban board is a visual workflow artifact used to display work items, identify bottlenecks, and optimize the flow of work. It typically consists of columns representing the stages of a process (e.g., To Do, In Analysis, In Development, Testing, Done).

The secret to Kanban is not the visual board itself, but the constraints placed upon it. A highway at 100% capacity is a parking lot; work only flows when there is breathing room in the system. To prevent gridlock, Kanban teams use Work in Progress (WIP) limits.
Work in Progress limits restrict the maximum number of work items allowed in a specific stage of a Kanban workflow at one time.
If the "Testing" column has a WIP limit of 3, and there are currently 3 items in that column, the developers cannot move a new item into Testing. They must stop developing and help the testers clear the bottleneck.
Measuring Flow
To understand how efficiently value is moving through the system, we measure three key metrics:
- Lead time measures the total elapsed time from the moment a customer request is made to the final delivery of that request. (The customer's perspective).
- Cycle time measures the total elapsed time required to complete a work item once actual work on that item has started. (The team's perspective).
- Throughput measures the number of work items passing through an agile team's workflow process over a specific period of time (e.g., "We deploy 5 features per week").
Analogy: Imagine ordering a custom laptop. Lead time starts the second you click "Buy online." Cycle time only begins three days later when the technician actually pulls your motherboard from the shelf and starts assembling it.
Advanced Flow Analytics
For deep analysis of a system's efficiency, project professionals turn to two advanced artifacts:
Cumulative Flow Diagram (CFD): A Cumulative Flow Diagram is an advanced agile chart used to track queue sizes, identify bottlenecks, and measure cycle time visually. It plots the number of work items in each column of the Kanban board over time as stacked, colored bands. If the band representing the "Testing" phase suddenly widens dramatically, you have found a bottleneck. The vertical thickness of a band shows your WIP; the horizontal width of a band shows your Cycle Time.

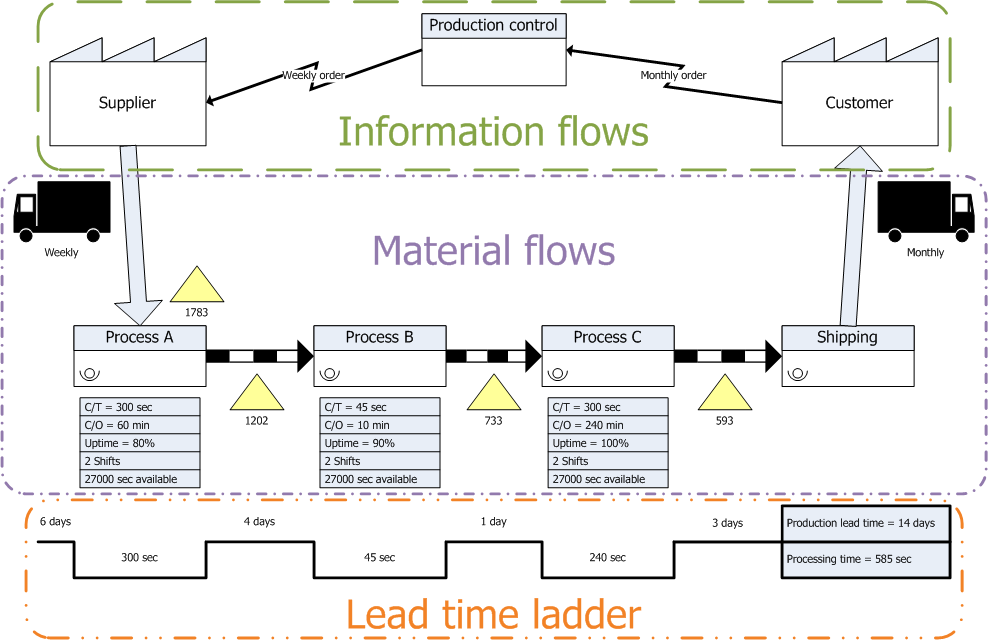

Value Stream Mapping: Finally, to optimize the entire lifecycle of a product from raw concept to customer delivery, organizations use Value Stream Mapping. This is an agile artifact used to analyze the flow of materials and information to identify and remove waste in a process. By mapping every single step, wait-time, and handoff required to deliver value, teams can spot non-value-adding activities (waste) and systematically engineer them out of existence.

In the CAPM exam context, remember this core distinction: Predictive project control asks, "Are we following the plan?" Adaptive project control asks, "Is the product we are building right now delivering value, and how can our living artifacts make that reality transparent to everyone?" Master the artifacts that answer this second question, and you will master adaptive project controls.
