Adaptive Task Management
Not sure you’re ready?
Take the ~3-minute readiness diagnostic and see where you stand.
Imagine a high-volume restaurant kitchen during a weekend dinner rush. If the expediter shouts out fifty complex orders at once and forces them onto the chefs' stations regardless of what they are currently cooking, the kitchen collapses into chaos. Burned food, forgotten tickets, and exhausted staff are the inevitable results. This is a push system—a dynamic where work is assigned to team members regardless of their current individual workload.
Instead, the most elite kitchens operate differently. A chef finishes a dish, clears their station, and only then looks to the ticket rail to take the next order. They pull work toward them exactly when they have the capacity to execute it. This fundamental shift from forcing work onto a team to allowing the team to draw work in is the cornerstone of adaptive task management. In the unpredictable environments where agile frameworks thrive, managing the flow of tasks is not about enforcing a rigid schedule; it is about maximizing the delivery of value through constant, sustainable execution.

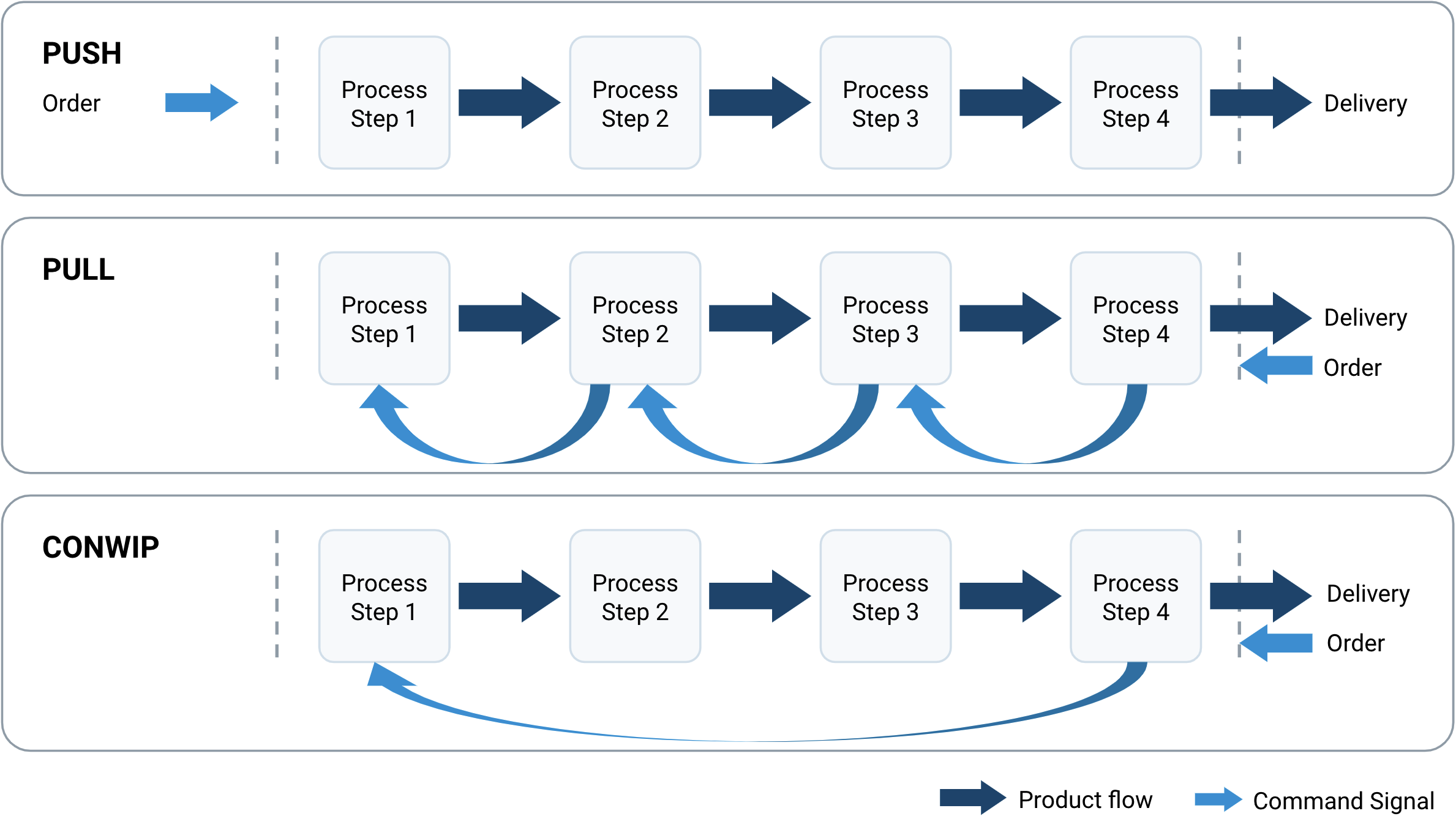

In traditional, predictive project management, a project manager acts as a dispatcher, pushing tasks to individuals based on a rigid Gantt chart. Agile task management relies on pull systems rather than push systems for task execution. A pull system allows agile team members to select specific tasks from the sprint backlog themselves. By trusting the process, adaptive project teams pull tasks from the backlog based on current team capacity.

To make this invisible flow of work visible, agile teams use Kanban boards. These boards visually track the workflow of tasks across different stages of completion (typically columns like To Do, In Progress, Review, and Done). However, simply visualizing the work is not enough to prevent traffic jams.

If a team pulls too many tasks into the In Progress column at once, context-switching destroys their productivity. To counter this, teams implement Work in Progress (WIP) limits. WIP limits restrict the maximum number of tasks allowed in a specific workflow stage on a Kanban board. Mathematically, WIP limits force teams to finish current tasks before starting new tasks, smoothing out bottlenecks and dramatically reducing the time it takes for a single task to travel from idea to reality.

Autonomy and Alignment
Because adaptive environments require rapid decision-making, micromanagement is a liability. Instead of a project manager dictating the "how," self-organizing teams determine the best technical approach to execute tasks.
Autonomy, however, requires constant communication to ensure the team remains aligned. This is achieved through the Daily Scrum, a 15-minute timeboxed event for the development team to synchronize task execution activities. It is not a status report to management; it is a daily huddle where the team inspects their progress toward the sprint goal and adapts their plan for the next 24 hours.
Before a team can execute a task, that task must be clearly defined and sized. In agile, requirements are rarely captured in massive, upfront specification documents. Instead, they are captured as user stories—short descriptions of a feature told from the perspective of the end user.
A standard user story format follows a strict psychological structure:
"As a [role], I want [feature], so that [benefit]."
By placing the end user's benefit at the end of the statement, the team never loses sight of why they are building a feature.

Sizing the Work: Story Points and Planning Poker
Humans are notoriously terrible at estimating work in absolute hours. If I ask you how many hours it will take to paint a house, your guess will likely be wrong. But if I ask you to compare the size of a dog house to a mansion, you can immediately tell me the relative difference.
Adaptive teams leverage this psychological trait by using story points, which represent the relative effort required to complete a user story, taking into account volume, complexity, and risk. To assign these points, teams often use Planning Poker, an agile estimation technique used to assign story points to product backlog items. Team members reveal their estimates simultaneously, sparking debate when estimates diverge, ultimately leading to a shared understanding of the task's complexity.
During sprint planning, the high-level user story is not what the developers actually code day-to-day. Agile teams break down user stories into smaller technical tasks during sprint planning.
But how does a team know if a user story is well-defined enough to bring into a sprint in the first place? They consult the Definition of Ready. The Definition of Ready establishes the minimum criteria a user story must meet before entering a sprint (e.g., it has been sized, dependencies are identified, and acceptance criteria are written).
In predictive projects, success is often measured by adherence to a baseline schedule or budget. In adaptive projects, these metrics are secondary. Working software is the primary measure of progress in agile task management. (Or, if you are not building software, the fully functional product increment).
To objectively determine if a piece of work is truly complete, agile utilizes a dual-layered quality checklist: Acceptance Criteria and the Definition of Done.
Acceptance Criteria vs. Definition of Done
Many aspiring project professionals confuse these two concepts. They are fundamentally different in scope:
- Acceptance Criteria are specific conditions a single user story must satisfy to be accepted by the product owner. They are unique to each individual user story. (e.g., "The login screen must lock the user out after three failed password attempts.")
- The Definition of Done, conversely, establishes the minimum criteria a product increment must meet to be considered complete. The Definition of Done applies universally to all tasks within a specific sprint or project. (e.g., "All code must pass automated testing, and release notes must be written.")
For a task to cross the finish line, a user story must meet its specific acceptance criteria to be considered complete, AND a user story must meet the universal Definition of Done to be considered complete.
Inspection and Tracking
At the end of an iteration, the team must prove they have generated value. A sprint review provides an opportunity to inspect completed tasks with stakeholders. Crucially, a sprint review includes a demonstration of the working increment to stakeholders—no slideware or promises, just the working product.
To visually communicate progress throughout the sprint and the project, agile practitioners rely on specific charts:
- Burndown Chart: Tracks the total amount of incomplete work remaining against the time left in a sprint. The line goes down as work is completed, aiming for zero by the sprint's end.
- Burnup Chart: Tracks the total amount of completed work toward a project goal. The line goes up as work is finished, clearly illustrating scope changes if the total project scope line also rises.
If execution is the engine of an adaptive project, prioritization is the steering wheel. Adaptive task prioritization focuses on delivering the highest business value earliest in the project timeline. This philosophy, known as value-driven delivery, ensures that agile teams prioritize tasks with the highest return on investment.
The Product Owner holds the primary accountability for prioritizing tasks in the product backlog. They must constantly filter noise from signal, ensuring the team is working on the most crucial items. Because agile environments are fluid, the product backlog undergoes continuous reprioritization based on changing stakeholder needs and market conditions. This is achieved through backlog refinement, the ongoing process of reviewing, updating, and reprioritizing product backlog items.
Agile eschews rigid, absolute priority numbers (like declaring 50 tasks as "Priority 1"). Instead, it uses relative prioritization, which ranks backlog items strictly against each other rather than assigning absolute priority levels. If item A is at the top, item B must be second; they cannot share the top spot.
To make these tough prioritization calls, Product Owners rely on several analytical models.
Prioritization Models for the CAPM Exam
1. The MoSCoW Method
The MoSCoW method categorizes tasks into Must have, Should have, Could have, and Won't have.
- Must have tasks in the MoSCoW method represent non-negotiable requirements for project success. If a "Must have" is absent, the product is useless or illegal to release.
- Should have: Important, but not vital right now.
- Could have: Nice to have if time and budget permit.
- Won't have: Explicitly excluded from the current scope.
2. The Kano Model

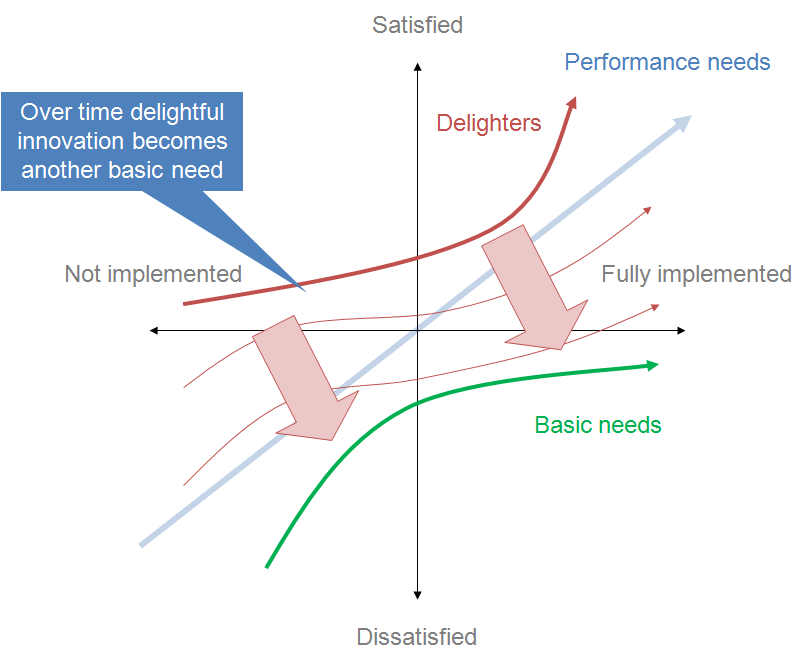

The Kano model categorizes features based on the degree of customer satisfaction provided by the features. It classifies features into three main categories:
| Category | Customer Reaction | Example |
|---|---|---|
| Must-be | Customers take these for granted. They won't delight them, but their absence causes outrage. | Brakes on a car. |
| Performance | Satisfaction increases linearly with execution. The more you provide, the happier they are. | Fuel efficiency. |
| Delighter | Unexpected features that cause immense positive reactions but cause no penalty if absent. | A built-in massager in the driver's seat. |

3. Value Versus Risk Matrix
Sometimes, prioritization requires balancing the financial upside against the danger of failure. A Value versus Risk matrix prioritizes tasks by balancing potential business value against associated risks.
- High-value and high-risk tasks receive the highest priority in adaptive project management. Why? Because if a major technical risk is going to kill your project, you want to fail fast, before you spend $500,000 building easy, low-value features.
- Low-value and high-risk tasks receive the lowest priority or are avoided entirely in adaptive project management. They simply aren't worth the danger.
4. Weighted Shortest Job First (WSJF)
Popularized by scaled agile frameworks, Weighted Shortest Job First is a prioritization model sequencing jobs based on the cost of delay divided by job duration. If two features deliver the same value, the one that can be built faster is prioritized. It mathematically ensures the team produces the maximum economic value in the minimum amount of time.
Mastering adaptive task management requires unlearning the habit of pushing work onto people and instead designing an environment where highly aligned, self-organizing teams can pull precisely defined, highly prioritized work. By leveraging clear acceptance criteria, continuous backlog refinement, and rigorous prioritization models, project professionals ensure that every hour of execution is directly translated into measurable business value.
